Share via


Project planning

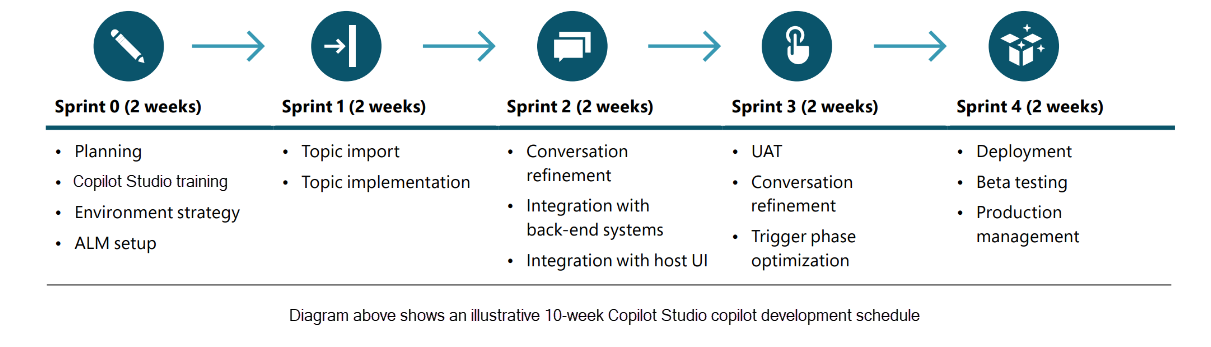

Copilot projects based on Copilot Studio can have different timelines and specifications depending on the use case and organization. However, one advantage that low code technologies bring is the rapid time to market as shown in the 10-week timeline.

Diagram displaying the sprint cadence required for Copilot Studio project planning.

Sample project overview and timelines

The advantages in choosing a rapid delivery timeline as your initial project phase include the following:

  • Accelerate customer adoption by first developing a minimum viable product.

  • Generate customer feedback (see Engage your flywheel) to provide insights on what can be improved.

  • Review insights to return value to your product and organization, enabling new developments faster.

Whether this approach is right for your use case depends on organizational need, support, and the ability to align the necessary workstreams.

Project workstreams

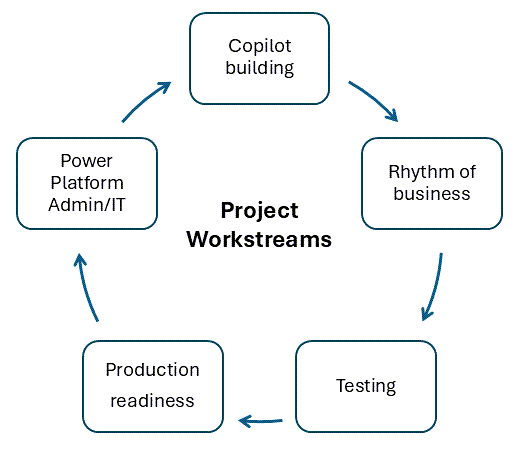

Diagram of the lifecycle involved with project workstreams.

Setting up an adoption platform requires several workstreams that can execute in parallel, each with their own goals, timelines, and owners.

The following five workstreams summarize and describe responsibilities:

Copilot building

  1. Build out related content for agent use cases.

  2. Content creation and development tasks.

Rhythm of Business (ROB)

A Rhythm of Business (ROB) meeting allows all participants to provide status updates and blocking issues, which stakeholders aim to resolve. These meetings should be actionable and driven by dates and business goals.

  1. Customer driven

    Microsoft and other partners attend.

    The customer is responsible for booking meetings and setting the agenda. Run this meeting as an engineering project with success metrics and scorecards.

    Activities and features for the meeting include:

    • Standup meetings for agent development, one or two times per week.
    • Weekly demos to show progress.
    • Weekly status update emails, highlighting blockers.
    • Bi-weekly bug prioritization.
    • Celebrate successes.
    • Periodic retrospectives.
    • Weekly office hours to support customers adoption.
    • Teams channel for open communication.
  2. Jointly owned

    Microsoft and other partners attend.

    • Architectural reviews guide core decisions for the platform.
    • Monthly executive reviews.
    • Scorecard review with progress, risks, blockers, and feedback.
    • Forum for demos.

Testing

User acceptance testing is a large part of delivering your Copilot Studio agent. Testing ensures the integration of the complete solution with the back-end, client API, and agent responses to customer input.

Production deployment and readiness checklist

Being assured that you're ready to deploy is a critical step to a successful launch.

Here are some considerations:

  1. Have all scenarios been tested to validate business requirements?

  2. Do you have a cutover plan that identifies all the activities required to successfully go live?

  3. Has this cutover plan been tested and validated?

  4. Do you have access to all the production resources you need?

    Resources such as:

    • Environments
    • DLP policies
    • Gateways (optional)
    • Azure resources (optional)
    • External APIs (optional)
  5. Do you have a communication plan to inform both internal and external stakeholders of the changes? This plan includes both pre- and post- deployment.

Power Platform administration

Many customers have Power Platform, Microsoft 365 administration, or a Center of Excellence (CoE) team that's accountable to the management of a technology set.

This team can focus on activities such as:

  • Environment setup.
  • Security/Access.
  • DLP Policies.
  • Gateways.
  • Custom analytics.

For more information, see custom analytics strategy.
